OK. We've finished our third season of building our papercrete palace.
We started in 2008. This first photo is the shot of our space after the first day's work.
That first season, we were only able to work 11 days, it was a total of 165 person hours.
Here is the picture at the end of that 11th day, in which we completed the north wall of our flat (or joint or palace), on the second floor, built above two guests rooms here at Eve's Garden Organic Bed and Breakfast in Marathon, Texas.
So, we started season two in March of 2009. This second picture is the end of our first day of the second season. The goal this year was to complete the east end of our main floor, which is the stairway up to the bedroom on the third floor, and the structure of the bathroom along with the dividing wall/arch that separates a small office from the big sitting room.
Here's Noble, architect, builder, all around brainy guy on the first half of the stairway finished after about 6 days into the work. In case you haven't seen the rest of the blog, those colorful windows in the arches are booze bottles cut in half, siliconed together and placed as glass block.
And, the block we use to build with is papercrete. We we make it right here at Eve's Garden out of recycled paper, recycled Styrofoam, sand, clay, pearlite and concrete.
Stairway completed and the east interior wall arch begun by day 15 in season 2.
A shot of Noble and I gazing adoringly at each other. Everyone knows how great it is to work day after day after day with your sweetie on a project like this, nothing but bliss and harmony.
This is what the east end of the joint looked like at the end of the 2nd season. We worked 30 days this season, a total of 412 person hours in 2009.
And, here's what we got done in Season 3:
This is Alaine's first major arch, on the south wall of the living room. This living room is about 16 foot by 16 foot, with an arch of this height. Next year, our goal is to put a ceiling on this room. Noble wants to build a groin vault, but he can't find much information on it, SEND YOUR IDEAS.
The nichos on either side of what will be french doors here are selenite rocks given to us by a great guy with a mine. His website http://www.crystallinephoenix.com
And this is the view of the west end of the joint (the kitchen), which will be the kitchen. When we started this season, there was only a two feet tall wall on the outside west wall and the south wall. Now all of the walls are done on All of the main floor of the house. Last season we got the roof on the other side of this level. This year we got the min-vaults here over the kitchen.
Total days worked in season three: 24 days.
Total person hours worked in Season three: 335.
I had reported that we have worked a total 55 days, I have to update that because I hadn't included six days making blocks and four days of working on preparations (framing windows, putting up forms, etc.)
So, the grand total of days that we've worked on our papercrete palace since 2008, so far is 65 days.
Grand total of person hours worked on the joint: 912 person hours.
Friday, June 11, 2010
Actualized, 65 days worked so far on Papercrete Palace
Posted by Alaine at 12:32 PM 3 comments
Labels: Marathon Texas, Papercrete
Wednesday, June 9, 2010
Day 55 Last day of Contruction for this Season!
Here it is! Mini-vaults completed over our kitchen-to-be! It took three days for the two of us to finish, but we reached our goal for the season. We just have one day to get our selves together to leave for the four day journey from rural West Texas, USA to the remote beach of Punta Uva, Costa Rica.
Day 3 raising the roof:
Wheel barrows Hauled up to 2nd floor: 10
Mud: 7
Block: 3
Wench pulls to 2nd floor:
10 wheelbarrows X 119 pulls = 1190 pulls
Bricks placed: 120
Steps up ladder to 3rd floor:
With Block:
3 blocks each trip is 120/3 = 40 trips up ladder with block
With Mud:
8 buckets per wheelbarrow went upstairs X 7 wheel barrows of mud =
56 trips up ladder with mud
Total trips up the 10 foot ladder today: 106 trips
7 to 10 steps up the ladder = 848 steps up the ladder.
Hours worked today: 10 to 6:30 = 17
24 + 27 + 17 = 68 total hours to put the roof up.
Beers fueling roof project: 12 + 4 + 1000 = 1,016
Posted by Alaine at 6:21 AM 0 comments
Tuesday, June 8, 2010
Day 54 Sixty Eight % Done With the Roof
Day 2 building the kitchen roof:
Wheel barrows Hauled up to 2nd floor: 14!
Mud: 10
Block: 4 (36 blocks in each wheelbarrow)
Wench pulls to 2nd floor:
14 wheelbarrows X 119 pulls = 1666 pulls!
Bricks placed: 144
Steps up ladder to 3rd floor:
With Block:
3 blocks each trip is 144/3 = 48 trips up ladder with block
With Mud:
8 buckets per wheelbarrow went upstairs X 10 wheel barrows of mud =
80 trips up ladder with mud
Total trips up the 10 foot ladder today: 128 trips
7 to 10 steps up the ladder X 128 trips = 1024 steps up the ladder.
Total person hours so far: 24 yesterday + 27 today = 51!
Total beers drunk to power the roof so far: 12 yesterday + 4 today (too tired to drink too much beer!) = 16
Kitty cats helping with construction: 0
Posted by Alaine at 6:58 AM 1 comments
Monday, June 7, 2010
Day 53 Raise the ROOF!
Day one of ceiling construction:
Total Wheel barrows Hauled up to 2nd floor: 11
Mud: 7
Block: 4 (36 blocks in each wheelbarrow)
Wench pulls to 2nd floor:
11 wheelbarrows X 119 pulls = 1309 pulls
Bricks placed: 120
Steps up ladder to 3rd floor:
With Block:
3 blocks each trip is 120/3 = 40 trips up ladder with block
With Mud:
8 buckets per wheelbarrow went upstairs X 7 wheel barrows of mud =
56 trips up ladder with mud
Total trips up the 10 foot ladder today: 106 trips
7 to 10 steps up the ladder = 848 steps up the ladder.
Person hours worked today: 24!
Beers drunk at end of day: 6 each!
Sore muscles: all of them!
Posted by Alaine at 6:45 AM 0 comments
Sunday, June 6, 2010
Day 52 Vigas!
Day 52!
Five days until departure from Marathon to Costa Rica and we got the vigas hoisted up so we can start the construction of our ceiling.
Clyde built a similar roof scape in 36 person hours. Noble and I aren't as speedy as Clyde, plus we have to haul everything from the ground now to the THIRD! Floor!
These beams are also recycled materials. They were used in a previous life as telephone poles. Noble and I carried them up here from the back yard. We think the heaviest one is about 100 pounds. I have to post a picture of my big muscles now at the end of the season. We're bulking up!
Posted by Alaine at 7:36 AM 0 comments
Labels: Papercrete, recycled construction
Saturday, June 5, 2010
Day 51 Kitchen Walls done REALLY!
Day 51
OK, now for sure we have built the walls up to roof level in the kitchen.
We decided to put a row of our home-made glass block all along the top of the walls. It's gorgeous, different combinations of blue and clear wine bottles.
TOMORROW, we'll get the beams across the roof so we can start constructing the mini-vaults as the roof! And finally we'll see this arch completed too.
Posted by Alaine at 7:29 AM 0 comments
Friday, June 4, 2010
Day 50 Walls in Kitchen UP
Day 50
Well, the walls in the kitchen are nearly up. You can see the bottles formed in an arch over the windows in the kitchen. They are mostly the beautiful sapphire blue Bombay Gin bottles that I brought (empty) in my suitcase from Costa Rica. Thanks ReciCaribe!
Also today we mixed a few extra handfulls of concrete in with the papercrete plaster mix so we have a very strong mix to plaster the Noble arch, cuz soon we put the vigas (beams) on top of this arch, so it has to be really strong.

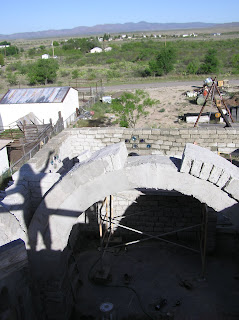

That's my shadow there on the left.
Posted by Alaine at 10:20 AM 0 comments
Labels: Marathon Texas, Papercrete
